Deepening Crisis: Godavari-Cauvery Interlinking Project

Godavari-Cauvery interlink has stalled as five states battle over routes, water shares, costs, and rights, leaving a major South Indian water solution trapped in disputes.

The Godavari-Cauvery river interlinking project began as an ambitious solution to South India’s chronic water problems. Now, it’s tangled in political and legal drama, going nowhere. Five states—Telangana, Andhra Pradesh, Tamil Nadu, Karnataka and Chhattisgarh—are locked in fierce disputes over everything from water shares to historical entitlements, route maps, and sheer distrust. The grand vision has stalled, and billions hang in limbo. Let’s take a closer, data-driven look at why this project has ground to a halt.

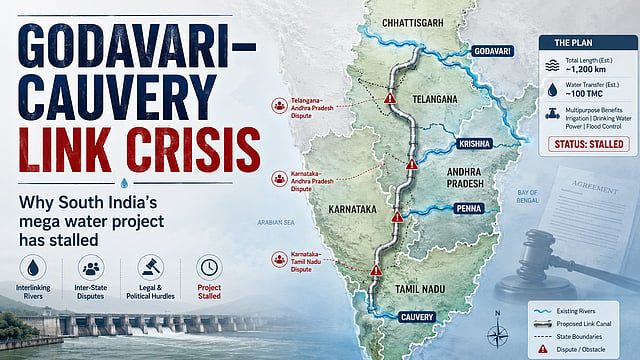

Blueprint: What’s the Mega-Link Project?

The National Water Development Agency mapped out a plan: divert surplus water from the Godavari River into the dry Krishna, Penna, and Cauvery basins. Instead of traditional open canals, the idea is to use advanced pressure pipelines. The motivation is clear—less land acquisition, less water lost to evaporation.

Project Details:

- Length: Roughly 1,211 kilometers

- Water to Divert: 141–148 TMC (Thousand Million Cubic feet) each year

- Estimated Cost: Between ₹39,275 and ₹63,868 crore

- Intended Beneficiaries: Tamil Nadu, Andhra Pradesh, Telangana, Karnataka

Phasing:

1. Godavari to Krishna (Nagarjuna Sagar)

2. Krishna to Penna (Somasila)

3. Penna to Cauvery (Grand Anicut)

Route War: Andhra vs. Telangana

On paper… it looks like a lifeline. In reality, without an inter-state agreement, it’s all deadlock. Every state has a different idea about what’s fair. Nothing divides the states more than where (and how) the water should flow. Andhra Pradesh flatly rejects the NWDA’s original route, which starts at Inchampalli in Telangana. Instead, AP wants to pull water from Polavaram’s right canal, run it through the Prakasam Barrage, over the Banakacherla cross-regulator, and eventually dump it into the Somasila and Cauvery basins. Their argument…this way, existing canals get used, land acquisition drops, and costs fall.

Telangana, meanwhile, is furious. AP’s proposed route sidesteps Telangana entirely, leaving it high and dry. BRS leaders and Telangana officials claim the Polavaram-Banakacherla route will drive the cost up to nearly ₹82,000 crore, while their suggested route through Telangana would cost around ₹48,000 crore.

Telangana’s Fight for Water Security

Officially, Telangana has lodged strong complaints with the Union Ministry of Jal Shakti. The state points out that its 968 TMC share of Godavari water (as per the tribunal) hasn’t been properly settled.

Telangana’s demands:

- The route must pass through its territory (either Inchampalli or Sammakka Sagar)

- The state wants a 50% share—about 70 TMC—of diverted water, especially for drought-blighted, fluoride-affected regions such as Nalgonda

For Telangana, this isn’t just debate. The state has dragged the issue before the Supreme Court (W.P. No. 1258 of 2025), challenging AP’s move to ramp up the Polavaram-Krishna diversion from an allowed 80 TMC to a staggering 200–300 TMC, all without Central Water Commission clearance.

Southern Thirst: Tamil Nadu and Karnataka

Further south, the project sets off a different kind of battle—a scramble for survival, wrapped up in historic rivalries. Tamil Nadu, desperate for water, scoffs at claims that Godavari has no surplus. TN says hundreds of TMCs get dumped into the sea every year, wasted. The DPR gives TN 41 TMC, but the state is pressing for 80 to 100 TMC—enough to meet Chennai’s drinking water needs and keep the Cauvery Delta’s farms alive. TN’s government is also lobbying hard for the project to be declared a “National Project,” which would mean the Union government foots 90% of the construction bill.

Karnataka complicates matters. Its decades-old feud with Tamil Nadu over Cauvery water only intensifies with this project. TN fears that once Godavari water flows in, Karnataka will use it as justification to block the natural Cauvery flow. Karnataka argues that, as the upper state, it deserves an equal share of the diverted Godavari water before it gets to Tamil Nadu. On top of everything, TN suspects the Centre might use this project as leverage to give Karnataka’s controversial Mekedatu dam the green light.

The Centre’s Balancing Act: 2025–26

Caught in the crossfire, the central government is doing its best to keep tempers from boiling over. They formed a 13-member technical committee in January 2026, under the CWC Chairman, to untangle the Krishna and Godavari disputes between AP and Telangana.

Other steps: the Krishna Water Disputes Tribunal’s deadline for recommending water redistribution now stretches to July 31, 2026. Clearly, no one expects an easy consensus.

Pragmatically, the Centre is floating a phased execution. Realizing agreement on Godavari diversion is a fantasy for now, they’re trying to start by moving ahead with just the Krishna-Penna-Cauvery leg. High-tech pipelines are meant to cut down on water theft and evaporation.

Hydropolitics… What next?

The Godavari-Cauvery interlink project lays bare India’s tangled federal hydropolitics. The potential: hundreds of thousands of hectares irrigated, big cities with steady drinking water supplies. The reality: deep mistrust, old grievances, and a confusing mess of competing claims. Without a transparent, evidence-based agreement—especially on what exactly “surplus” means—this massive project will stay stuck. The courts and political wrangling won’t let it move forward until everyone sees a fair deal written in data, not just promises.
